Pre-Completion Variations (During Work)

The Contractor uses this when additional work is needed before completing the job.

While reviewing or starting the work, Contractor determines:

      Additional materials needed

      Extra scope of work required

      Different approach necessary

To submit a Variation Request:

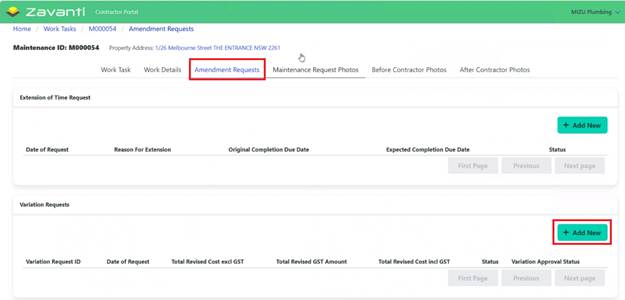

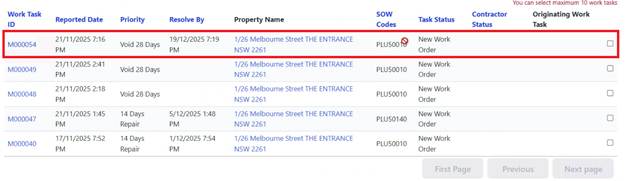

1.  Open the Work Task

A screenshot of a computer

AI-generated content may be incorrect.

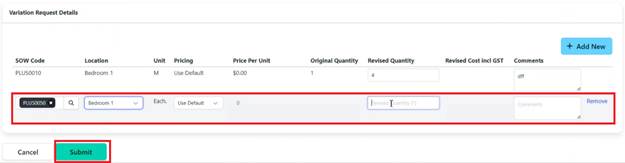

2.  Click ‘Add New’ in the amendment Request section

A screenshot of a computer

AI-generated content may be incorrect.

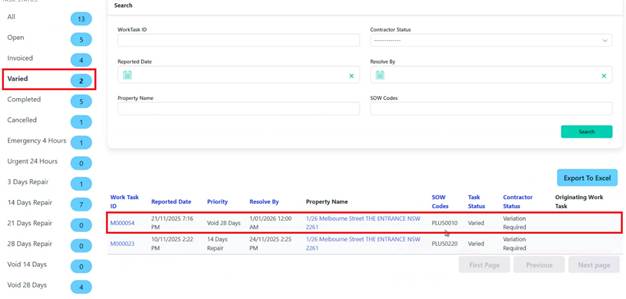

3.  Review existing Work Details (original SOW codes displayed)

A screenshot of a computer

AI-generated content may be incorrect.

4.  Add new line items as needed:

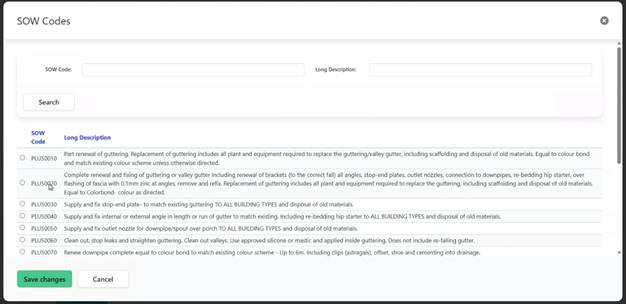

Select SOW code (or Request if not listed)

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

Enter location

Specify quantity

Enter revised cost (if applicable)

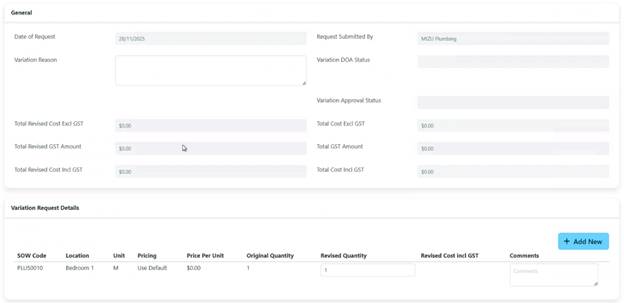

5.  Click ‘Submit’ for approval

A screenshot of a computer

AI-generated content may be incorrect.

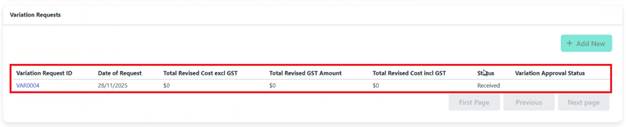

6.  Variation Request status shows as ‘Received’

A screenshot of a computer

AI-generated content may be incorrect.

The Variation Request follows CHP's Delegation of Authority (DOA) workflow:

      First Level: Assets Officer reviews

      Additional Levels: Based on dollar amount, may escalate to:

Team Leader

Asset Manager

CFO

CEO

Contractor will receive notification via:

      Email confirming approval or rejection

      SMS notification

      Portal status update

If approved:

      Original Work Task marked as ‘Varied’ and closed

A screenshot of a computer

AI-generated content may be incorrect.

      New Work Task created (e.g., original #54 becomes #54-1) and automatically sent to Contractor

A screenshot of a computer

AI-generated content may be incorrect.

      Updated Work Details reflect approved Variations

A screenshot of a computer

AI-generated content may be incorrect.

      The Contractor can proceed with completing the work
